A Proposal for Design Services

976 Notch
/ Nayara

Prepared by

Keown Liang

Prepared for

Ben Crespi, Lead Developer

Date

April 27, 2026

01

Project Vision

The 976 Notch project is a rare opportunity to craft a retreat that earns the landscape it sits within, at the foot of Mount Greylock in North Adams, Massachusetts. The program weaves thermal bathing, outdoor recreation, and contemplative gathering into a single continuous experience of the Berkshire hillside.

The site plan features a main lodge, a major spa and wellness facility, food and beverage venues, and 49 guest cabins scattered across a wooded hillside, interconnected by cart paths and walking trails.

Keown Liang will serve as Design Architect, shaping the interior architecture, materiality, and furnishings across every touchpoint of the guest experience. Our mandate is to reimagine the aesthetic, materiality, and emotional resonance of the project while maintaining the approved programmatic data.

Our approach, rooted in primitive materialism, privileges elemental materials, spatial restraint, and the quiet power of craft. We believe the architecture should defer to the landscape, creating a place where the built environment and the Berkshire hillside become one continuous thing.

162,845

Total SF

49

Guest Keys

3

Cabin Types

Berkshire range from the 976 Notch site
02

The Program

Full design services for the following structures, totaling approximately 162,845 SF. Each space receives the full weight of our attention, from the fee structure to the final finish selection.

Public Spaces & Amenities

8 Buildings

Main Lodge

12,990 SF

Lobby, reception, main restaurant, bar/lounge, kitchen, and lower-level BOH support.

Building 1

Spa & Wellness

20,330 SF

Thermal pools, gym, saunas, steam room, treatment rooms, lockers, and resting lounge.

Building 2

Welcome / Valet

1,200 SF

Arrival structure.

Building 7

Recreation

3,200 SF

Indoor recreation, wilderness guides, and gear room.

Building 8

Yoga Pavilion

1,225 SF

Dedicated wellness pavilion.

Building 9

Events Pavilion

3,500 SF

Special events structure.

Building 11

Art Studio / Library

3,000 SF

Guest-facing creative space.

Building 12

Pet Services

1,000 SF

Kennel and wash area.

Building 13

Food & Beverage

2 Buildings

Specialty Restaurant

3,000 SF

Adaptive reuse of the existing farmhouse with a new modern addition.

Building 5

Coffee Pavilion

2,000 SF

Standalone beverage and refreshment pavilion.

Building 10

Guest Cabins

3 Unique Prototypes / 49 Keys

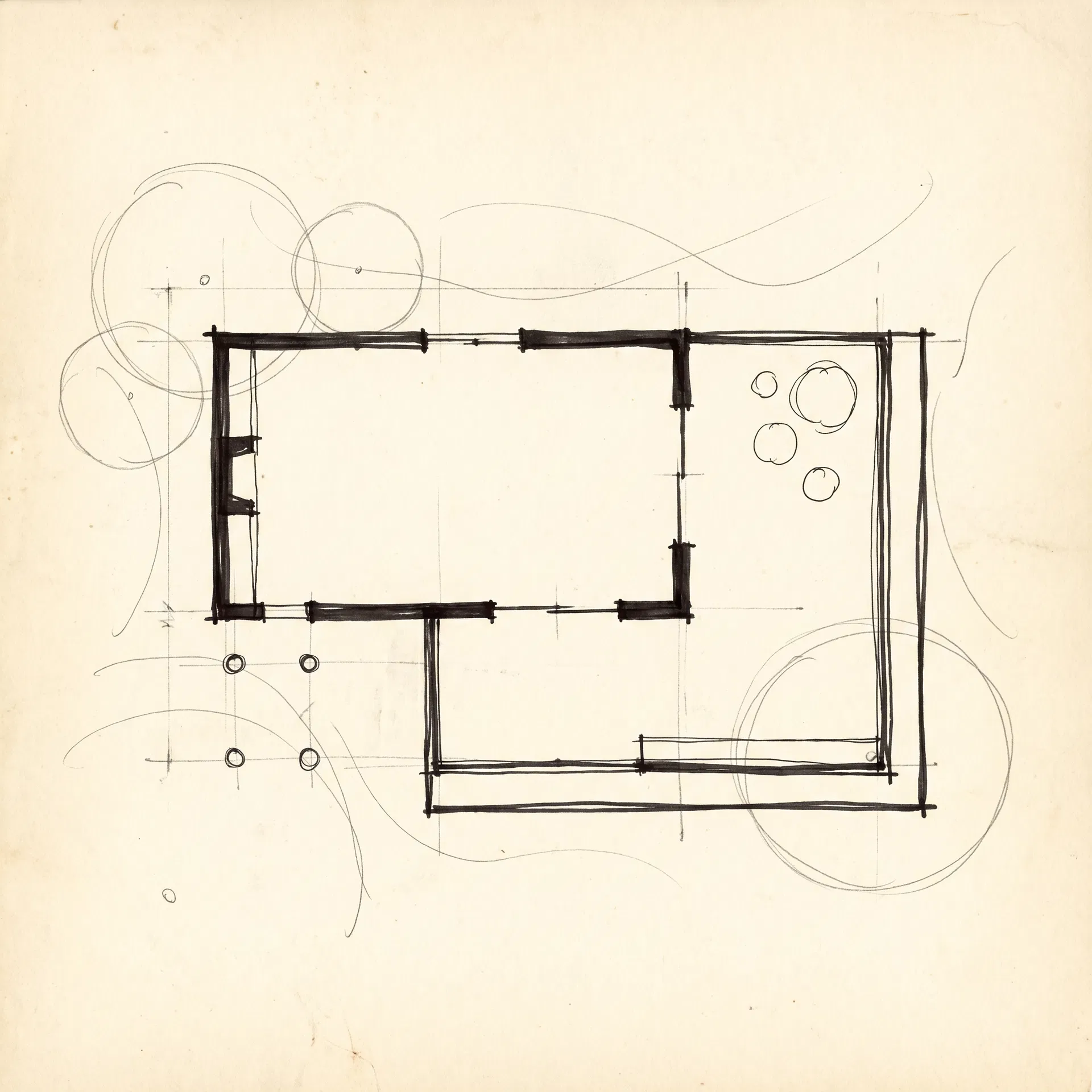

Tree Cabin preliminary floor plan sketch

Tree Cabin

1,940 SF

Elevated, cantilevered design with outdoor deck, fire pit, and hot tub.

Type A

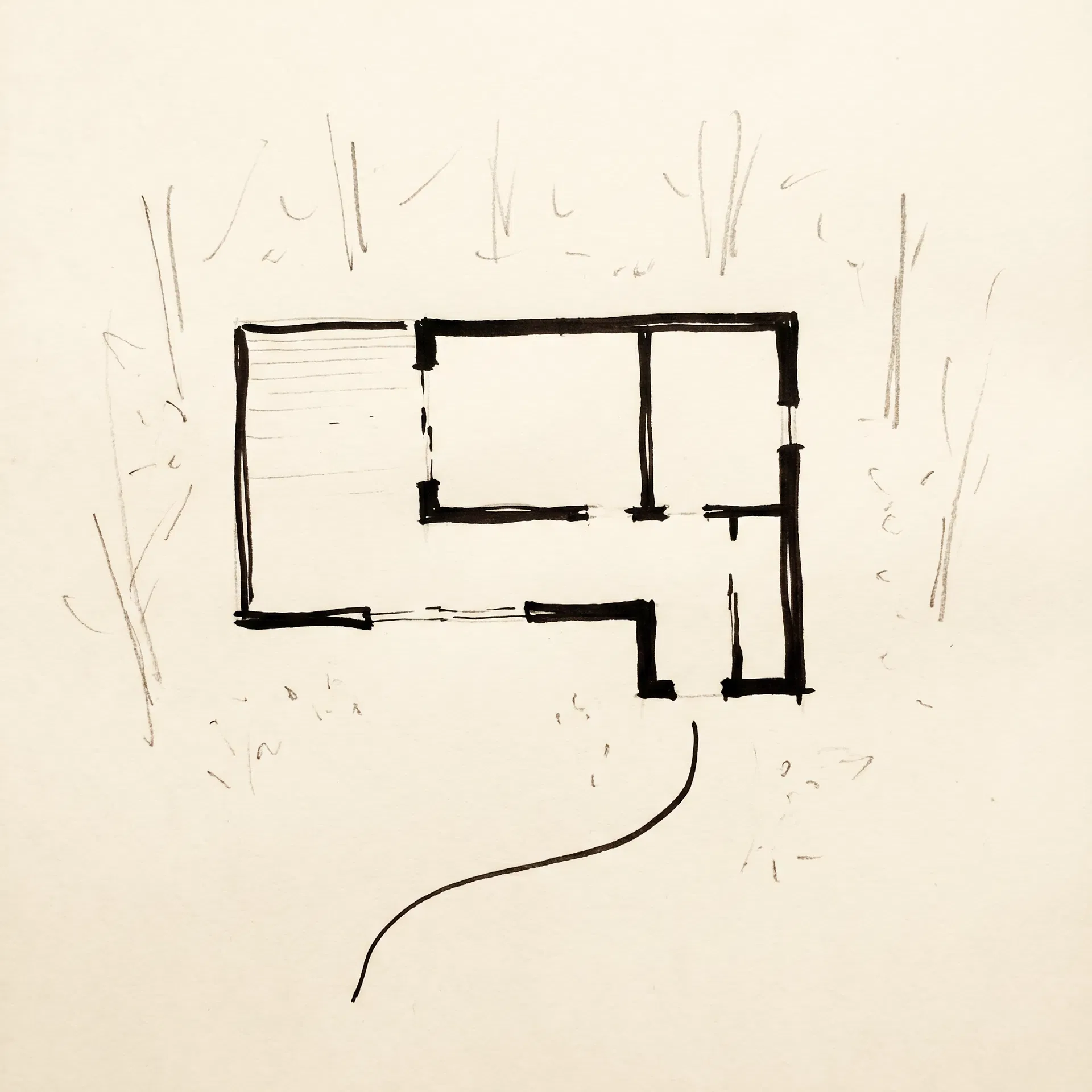

Woods Cabin preliminary floor plan sketch

Woods Cabin

1,940 SF

Ground-level forest design with outdoor deck, fire pit, and hot tub.

Type B

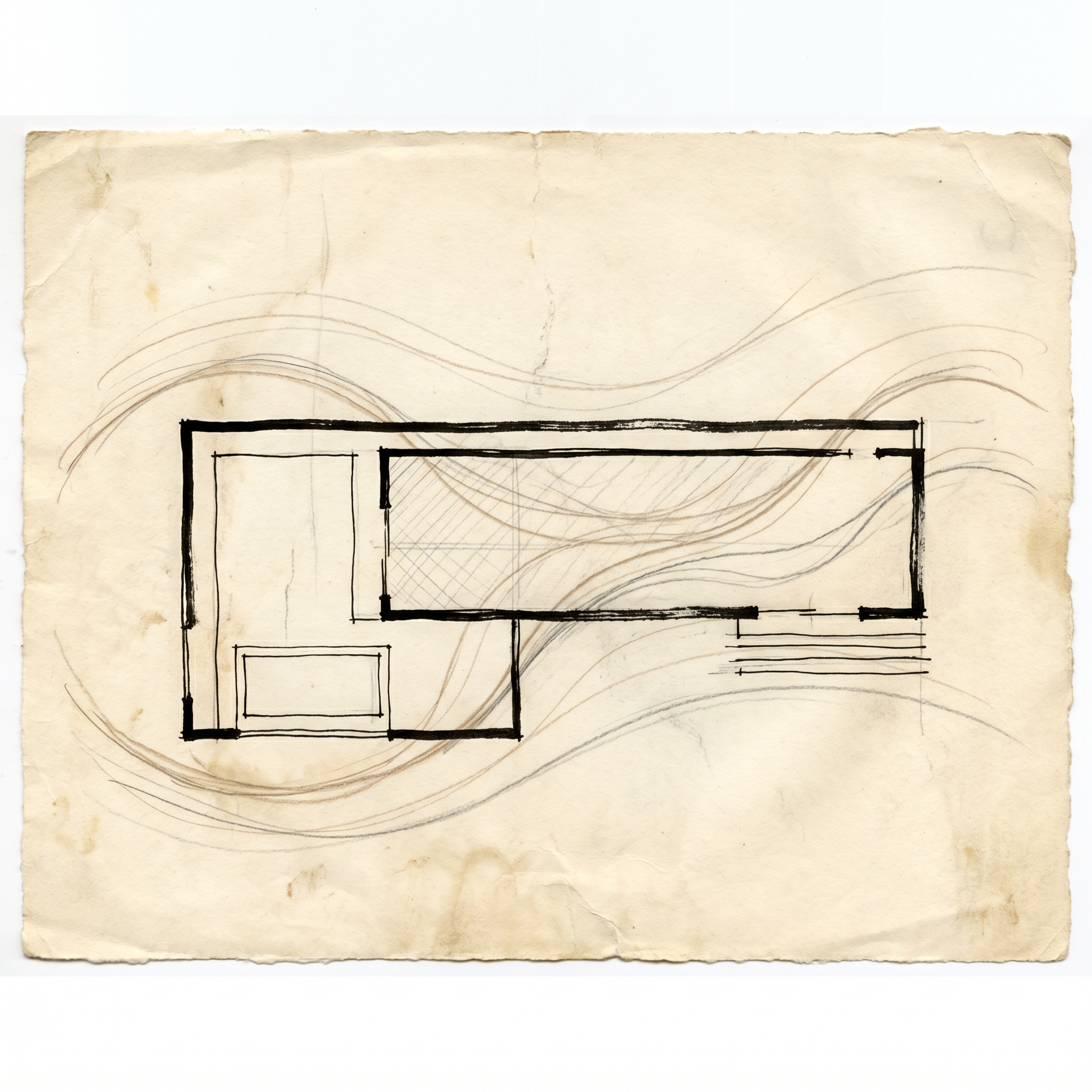

Meadow Cabin preliminary floor plan sketch

Meadow Cabin

1,940 SF

Ground-level open meadow design with living roof, plunge pool, and fire pit.

Type C

Plus one (1) fully operational Model Cabin with complete FF&E procurement support.

Back of House

Buildings 3, 4, 6, 14a/b/c

16,340 SF total. Staff offices, employee dining, receiving, laundry, maintenance, and housekeeping stations. Keown Liang will provide basic architectural services and finish selections for these utilitarian spaces.

03

Our Approach

As Design Architect, Keown Liang will provide full Interior Architecture and FF&E Design Services, including interior layouts, fenestration direction, architectural lighting, millwork, and elemental finishes.

The work unfolds across six distinct phases, each building on the last, from the first site analysis through construction administration. Our First Steps package covers the first two phases, establishing the creative foundation and working rhythm before the full engagement begins.

Fieldstone boulders with Mount Greylock beyond
04

Design Phases

01

Preliminary Design

Site and program analysis, Concept Deck, and Preliminary Design Documents.

8 weeks

Weeks 1–8

02

Schematic Design

Zoning envelope studies, blocking plans, floor plans, and perspective studies.

12 weeks

Weeks 9–20

First Steps Package

Preliminary Design + Schematic Design. 20 weeks. $337,000

03

Design Development

Comprehensive DD Documents including floor plans, elevations, sections, material palettes, and color renderings.

16 weeks

Weeks 21–36

04

Construction Documents

Full interior CD sets for permitting and construction.

14 weeks

Weeks 37–50

05

Bidding & Negotiation

Support during the contractor selection and bidding process.

6 weeks

Weeks 51–56

06

Construction Administration

Site visits, submittal review, RFI responses, and final punch list.

18–24 months

Weeks Ongoing

05

Investment

Keown Liang operates with a lean, senior-heavy team, ensuring that every project receives direct, continuous attention from the founders.

Scope CategoryInterior ArchitectureFF&E DesignCombined Total
Arrival / Welcome$38,000$8,000$46,000
F&B (All Venues)$580,000$142,000$722,000
Spa & Wellness$604,000$70,000$674,000
Guest Cabins (3 Types)$197,000$50,000$247,000
Amenities & Recreation$261,000$52,000$313,000
Back of House$92,000$10,000$102,000
Model Cabin$59,000$85,000$144,000
Grand Total$1,831,000$417,000$2,248,000

Cabin pricing is based on the design of three unique prototypes, not the total key count of 49 units.

Architect of Record Add-On

If ownership prefers Keown Liang to serve as the Architect of Record, producing full architectural construction documents, managing structural/MEP coordination, and leading the architectural CA process, this scope is available as a separate add-on. We are comfortable proceeding either way, whether acting as full AoR or collaborating with a local executive architect. See the responsibilities matrix for how this shifts the division of work.

$680,000

Reimbursable Expenses

Billed at cost. As a boutique practice, we maintain minimal overhead. Given the project's location in North Adams, MA, we anticipate utilizing car travel from our NYC studio, which significantly reduces travel costs compared to typical destination resorts.

$14,700

Travel (24 trips)

$15,000

Print / Ship / Misc

$29,700

Total Est.

06

The Team

A lean, senior-heavy practice. Every project receives direct, continuous attention from the founders.

Drew Stuart

Principal

$275/hr

Jean Lin

Design Director

$275/hr

Schedule of Hourly Rates

CategoryHourly RateTravel Rate (80%)
Principal (Drew Stuart)$275$220
Design Director (Jean Lin)$275$220
Senior Designer$150$120
Designer$100$80
Administration$65$52

Rates apply to Additional Services. Subject to annual adjustment.

07

Project Timeline

Assumes a Notice to Proceed within 30 days of proposal acceptance. Actual durations subject to Owner review periods, consultant coordination, and permitting timelines.

W1W10W20W30W40W50W57
First Steps (20 wks)
PD
SD
DD
CD
B&N
Notice to ProceedWeek 1
Concept Deck PresentationWeek 6
Preliminary Design CompletionWeek 8
Schematic Design PresentationWeek 16
Schematic Design CompletionWeek 20
DD 50% ReviewWeek 28
Design Development CompletionWeek 36
CD 50% ReviewWeek 43
CD 90% ReviewWeek 48
Construction Documents CompletionWeek 50
Bid Package IssuedWeek 51
Construction StartWeek 57 (est.)

Owner review periods of up to 10 business days are assumed at each phase milestone.

Construction Administration phase runs concurrent with construction, estimated at 18-24 months.

Oak trees on the 976 Notch hillside at golden hour
08

Responsibilities

Division of responsibilities between Keown Liang (KL), the Executive Architect (EA), the Owner (O), and Owner's Consultants (C). If Keown Liang is engaged as Architect of Record under the AoR Add-On, responsibilities marked "EA" would transfer to KL.

Design Services

ResponsibilityKLEAOC
Interior Architecture DesignLeadSReview
Exterior Architecture Design DirectionLeadSReview
Interior Layouts / Floor PlansLeadReview
Fenestration / Window Design DirectionLeadSReview
Architectural Lighting DesignLeadReviewS
Decorative Lighting DesignLeadReview
Millwork / Cabinetry DesignLeadReview
Material / Finish SelectionsLeadReview
FF&E SpecificationsLeadReview
FF&E Procurement CoordinationLeadReview
Custom Furniture DesignLeadReview
Art Curation / PlacementLeadReview
Signage / Wayfinding DirectionLeadReviewC

Architectural Services (AoR Add-On or EA)

ResponsibilityKLEAOC
Building Code ComplianceSLead
Structural CoordinationSLeadC
MEP CoordinationSLeadC
Life Safety / Fire ProtectionLeadC
Construction Documents (Architectural)SLead
Permitting / FilingSLeadO
Specifications (CSI Format)SLead

Construction Phase

ResponsibilityKLEAOC
Site Visits (Design Intent)LeadS
Site Visits (Construction Compliance)SLead
Submittal Review (Finishes / FF&E)Lead
Submittal Review (Architectural)SLead
RFI Responses (Design Intent)LeadS
RFI Responses (Technical)SLead
Change Order ReviewSLeadO
Punch List (Design)LeadS
Punch List (Construction)SLead
Model Cabin CoordinationLeadSO
09

Terms & Conditions

Standard terms governing the engagement. Click to expand each section.

Design software: Current industry-standard software. Digital files provided in compatible formats upon request.

Natural pond surrounded by wildflowers and wooded hillside
10

First Steps

Begin the Creative Process

To establish our working rhythm, we offer an initial "First Steps" engagement covering the Preliminary Design and Schematic Design phases. This amount will be credited against the total design fee upon moving into Design Development.

$337,000

First Steps Fee

20 weeks

Duration

Keown Liang

Drew Stuart & Jean Lin, Founders

This proposal is valid for thirty (30) days from the date of issuance.
